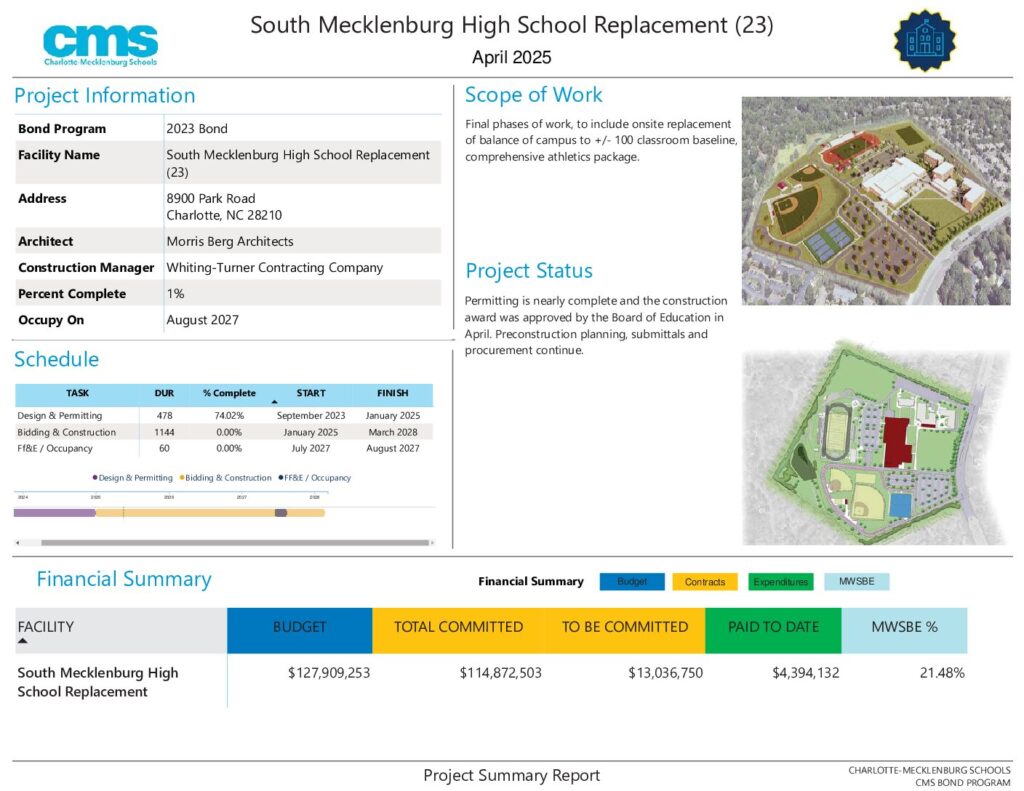

Final phases of work, to include onsite replacement of balance of campus to +/- 100 classroom baseline, comprehensive athletics package.
PROGRESS
Permitting is nearly complete and the construction award was approved by the Board of Education in April. Preconstruction planning, submittals and procurement continue.
