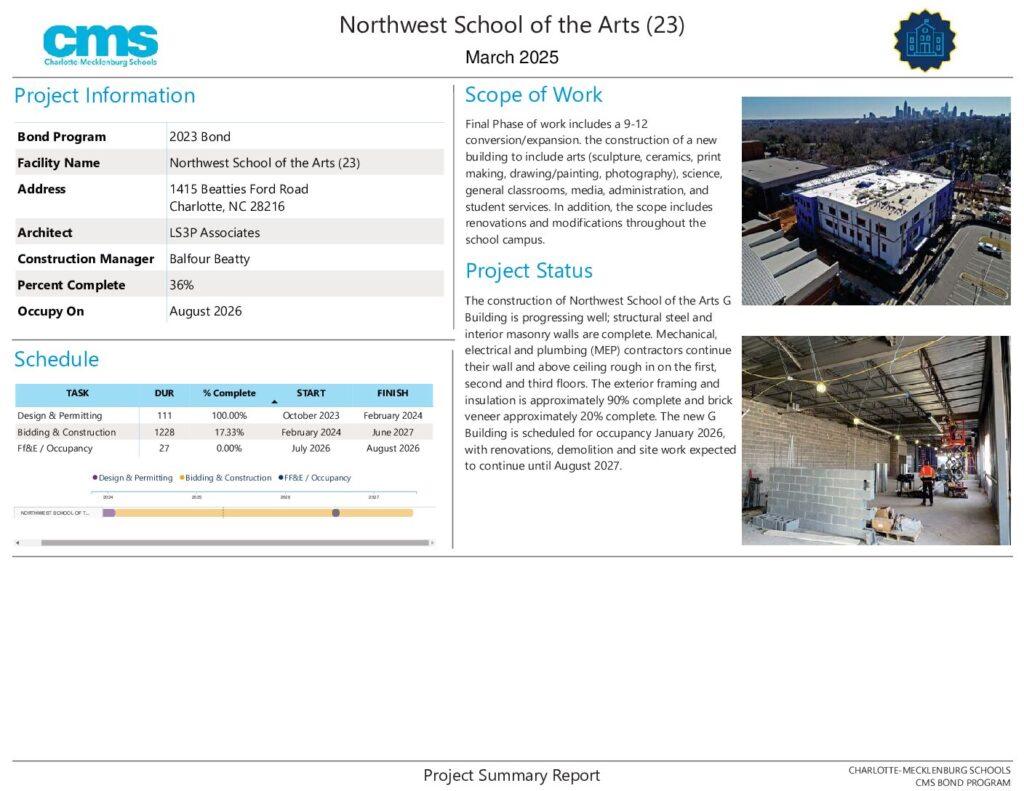

Final Phase of work includes a 9-12 conversion/expansion. the construction of a new building to include arts (sculpture, ceramics, print making, drawing/painting, photography), science, general classrooms, media, administration, and student services. In addition, the scope includes renovations and modifications throughout the school campus.
PROGRESS

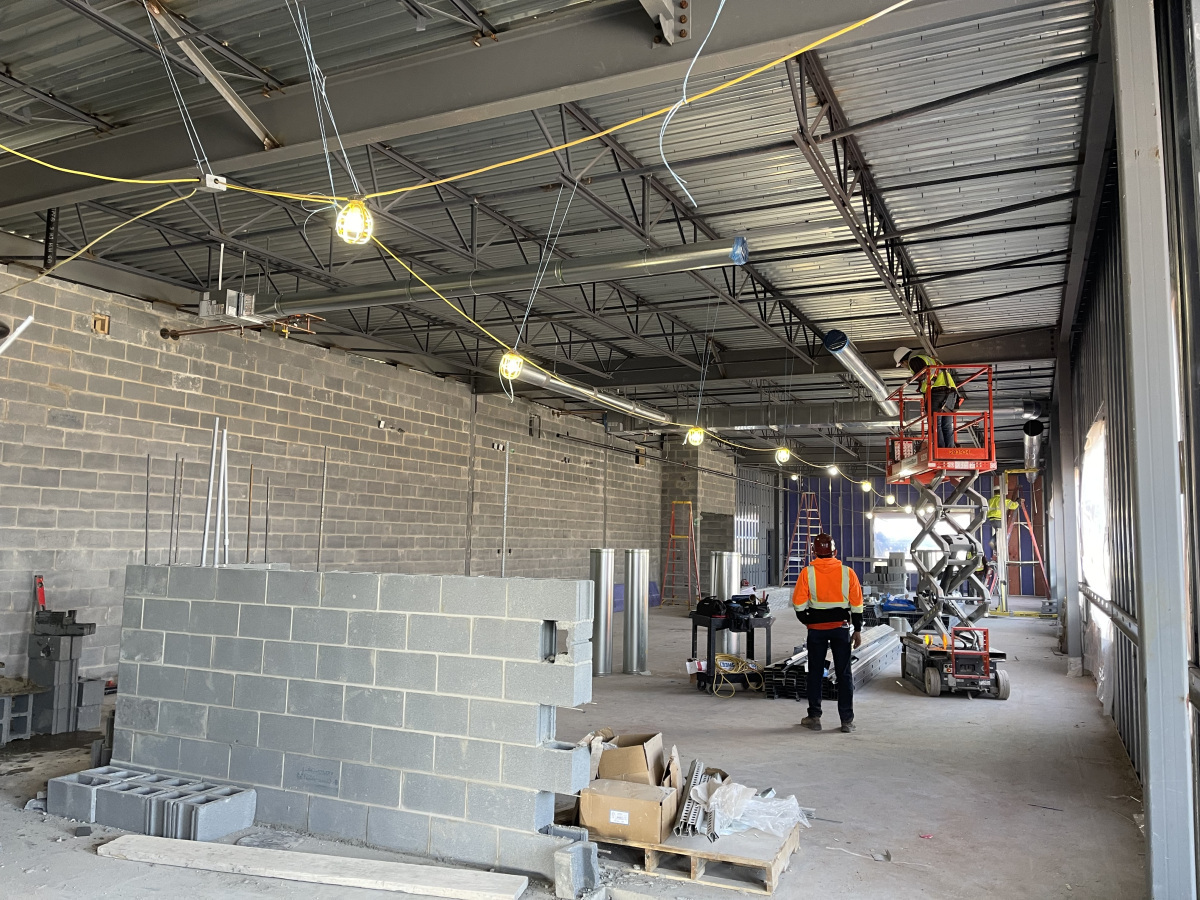

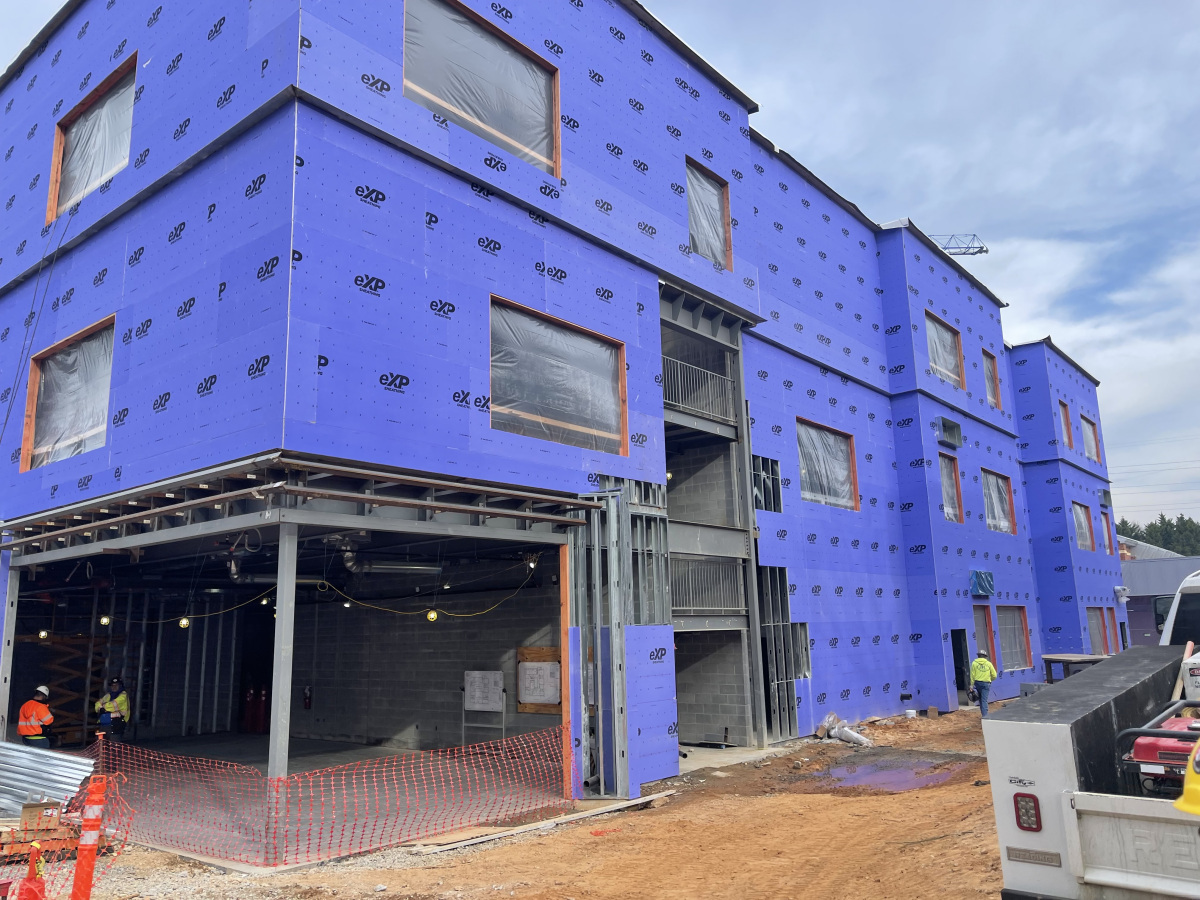

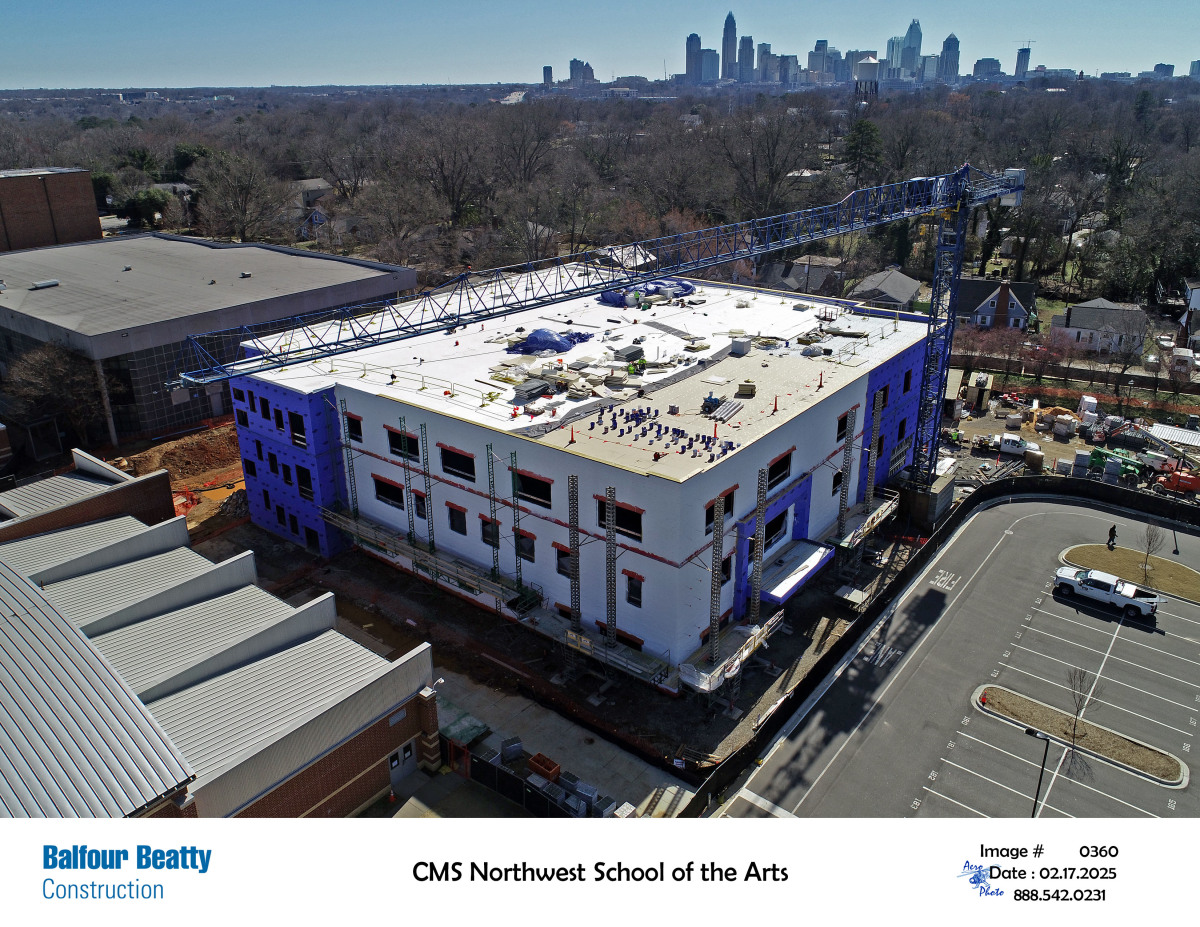

Construction continues with the interior renovations in Building C, and site work for the greenspace between Building C and the Cafeteria. Construction completion is currently scheduled for first quarter of 2027.
